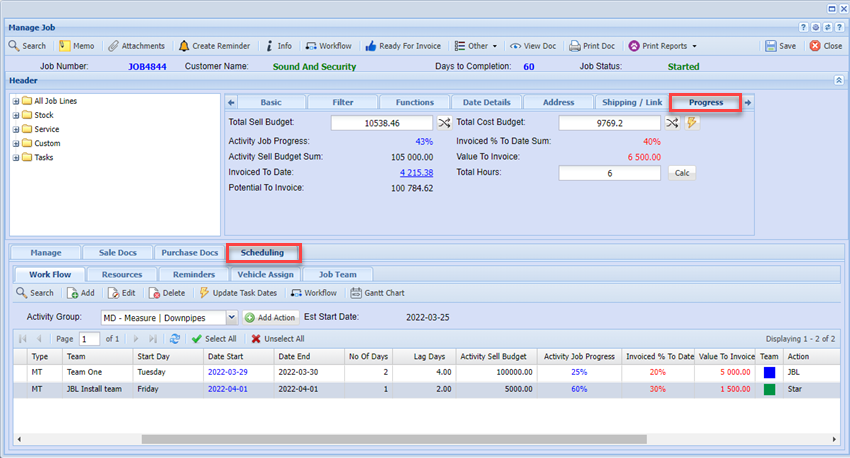

Progress Tab

The Progress tab gives summary totals based on the scheduling task values



Total Sell Budget

This figure is first inserted when you promote the quote to a job - It is the total sell value excluding of quote

You can manually update this figure

Total Cost Budget

This figure is first inserted when you promote the quote to a job - It is the total cost value excluding of quote

You can manually update this figure

Activity Job Progress %

This is the sum total of the percentage entered into the schedule tab for task activity groups as a percentage complete

Activity Sell Budget Sum

This is the sum total of the values entered into the schedule tab for task activity groups

Invoiced to date

This is the sum total of all the actual invoices processed - Value shows as the sell excluding

Potential to invoice

This is the same difference between the activity sell budget less the invoice to date figure

Invoiced % to date Sum

This is the sum total of the percentage entered on the task activity

Value to Invoice

This is worked out as the value to invoice based on the invoice percentage selected on the task activity lines

Total Hours

Manually entered by user to give total hours required for job



Click on the lightning bolt button to update the total sell budget and total cost budget from the first quotation.

Click on the calc button to update all the figures in the progress tab.
